Arapahoe County proposes development fee for $68 million I-70 interchange

The county projects $45.5 million in fee revenue for the Airpark Road project; the plan also identifies a $22.5 million funding gap and anticipated metro-district borrowing.

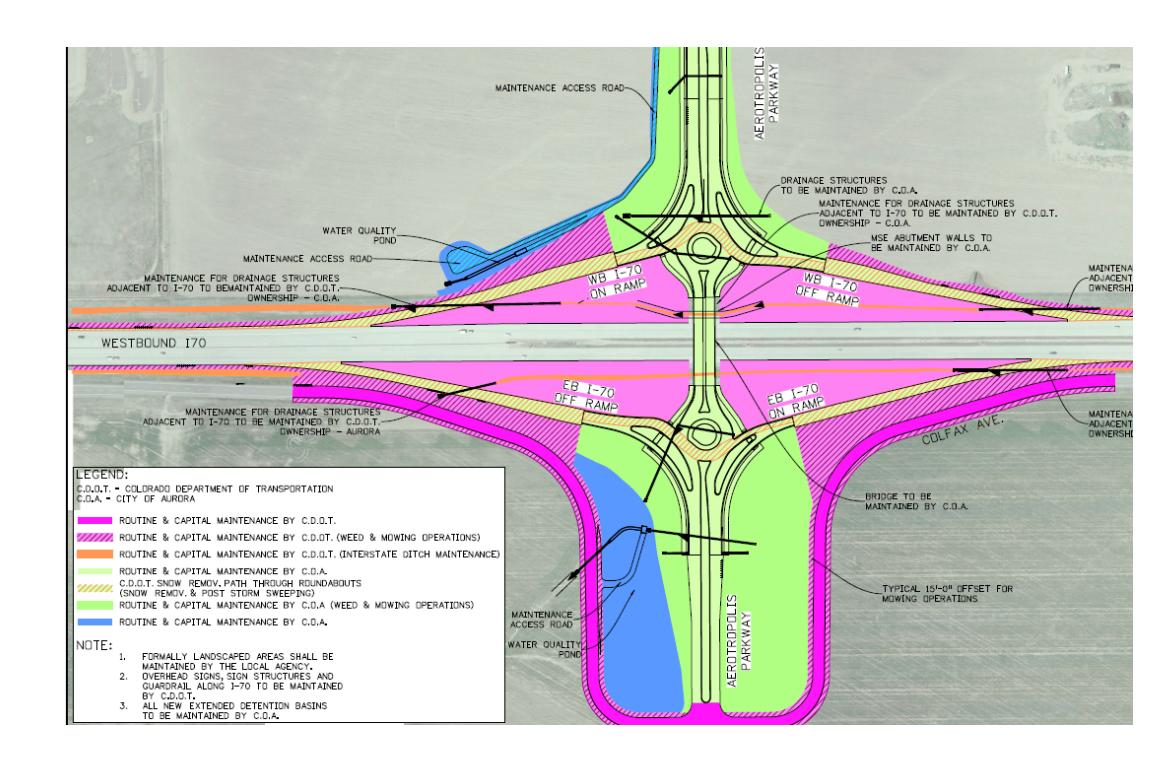

Color-coded plan diagram of the proposed road interchange, showing roadways and ramps.
Color-coded plan diagram of the proposed road interchange, showing roadways and ramps.

Published at

Arapahoe County staff have outlined a financing plan for a new I-70/Airpark Road interchange that would use a development fee and anticipated contributions tied to growth in Aurora. The county estimates the project will cost $68 million, including financing. The fee and funding agreements have not been approved; the plan is among materials prepared for a Sept. 29 Board of County Commissioners study session.

The estimate includes $40 million for construction and $28 million in financing costs. The county projects $45.5 million in impact-fee revenue—about $34 million from Sky Ranch development and $11.5 million from Eastgate—leaving a projected $22.5 million gap. The county presentation says the gap would be covered by $5 million from existing development and a $17.5 million pro-rata share associated with Aurora development. Those amounts are projections, not final payment commitments.

The presentation also lists $22.5 million in Regional Improvement Mills currently being assessed by the Sky Ranch Metro District. The county expects the Sky Ranch and Eastgate metro districts to issue bonds backed by impact-fee and mill revenue, with each district responsible for its own debt. The county’s Board summary describes other, narrower Sky Ranch commitments: about $500,000 for prior studies, about $500,000 for improvements to the existing interchange, and funding for design. A separate agreement makes the Sky Ranch developer responsible for $923,765 in costs for the Colorado Department of Transportation’s approval process under Section 1601.

The proposed fee would apply to qualifying new residential and non-residential development in a roughly six-square-mile area of eastern, unincorporated Arapahoe County. Under the draft resolution, development requiring a county building permit would pay before the permit is issued. Residential fees would be charged per dwelling; non-residential fees would depend on land use and gross floor area. For example, the draft lists a single-family home fee of $7,854 in the higher-fee tier and $826 in the lower-fee tier. A convenience store with gas would pay $83,180 or $8,752 per 1,000 square feet, depending on the tier. The resolution says the fee is intended to cover a proportionate share of capital improvements needed because of growth, not existing deficiencies unrelated to new development.

The resolution is still a draft, with its adoption date and vote fields blank. Staff materials propose a public meeting to consider the fee in November. Staff also sought support for an agreement to distribute impact-fee revenue to the metro districts; that agreement would follow fee adoption. The draft agreement is unsigned and does not establish final payment shares.

The county expects to send the transportation department a system-level study and 30% design documents in fall 2026, then negotiate construction and maintenance agreements after the department’s review. The Board summary says those agreements are expected to return to commissioners in late 2027 or early 2028. Final cost shares and responsibility for ongoing maintenance remain to be worked out.
